Skip to content
← Back to Work
Product · PO

Bulk Copy

  • Async Batch
  • Whitelist Validation

Summary

I planned bulk copy to replace the repeated creation of individual re-contracts with loading existing contracts, editing only what changes, and creating them together. The platform’s first use of Excel-style UI retains the familiar workflow while adding input validation and connecting collection-work and schedule transfers.

Role
Product Owner (planning lead, policy definition, UI and workflow design)
Outcome
Bulk contract creation, familiar Excel workflow retained, linked work and schedule transfers

Problem

Repeating Creation and Transfers for Every Re-contract

Price or disposal-facility changes often required multiple re-contracts while retaining most existing information. The CX team listed the targets in Excel, then created each contract individually or asked developers to insert the contract data. Operators handling creation themselves repeated the same procedure for every target.

POs retrieved existing contract information through Metabase, while operators manually copied collection manuals, notes, and tags into the new contracts. The Allbaro disposal plan did not carry over and needed separate attention. Information missed during registration became individual requests for developer corrections followed by another review.

Transfers remained after the contracts were created. Accounting listed the previous contracts’ unbilled collection work, while operations listed the work that needed schedule changes. Each team processed its list item by item or passed it to developers for data changes and reviewed the results afterward. Creating multiple re-contracts therefore repeated not only contract creation but also the preparation, handoffs, and follow-up checks across three teams.

Planning Decision

Preparing Contracts Together While Retaining the Excel Workflow

I prioritized bulk copy over bulk editing because recurring requests involved creating multiple re-contracts from existing information rather than modifying the existing contracts.

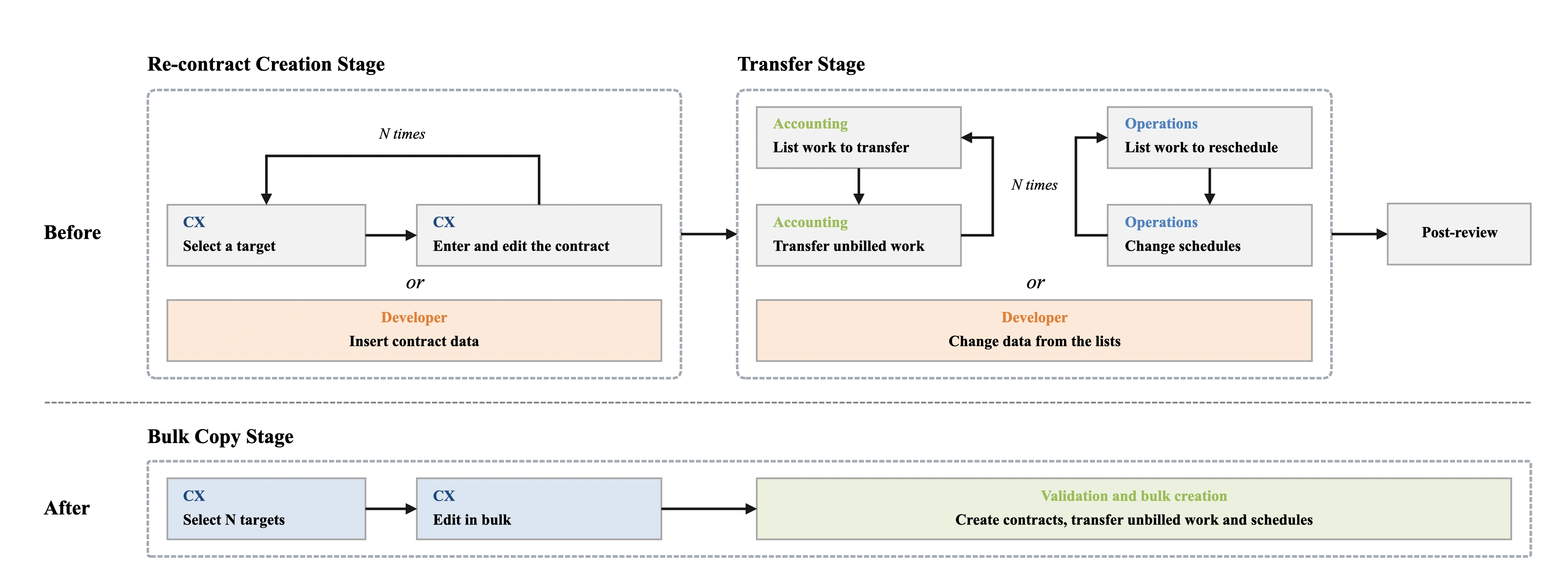

N contracts due for re-contracting: Work that runs from contract creation to unbilled-work transfers and schedule changes. Previous workflow (Each team handled contract creation and transfers separately) → Contract creation stage, CX selects a target, then enters and edits the contract, N times over, or developers insert the data → Transfer stage, Accounting lists the work to transfer while operations lists the work to reschedule; they then transfer unbilled work and change schedules, N times over, or developers change the data from the lists → Post-review, Check the created contracts and the transfers again. Redesigned workflow (Everything through the transfers finishes in the single bulk copy stage) → Select N targets, CX selects the contracts to re-contract at once → Edit in bulk, Change values across contracts, with validation → Validation and bulk creation, Unbilled work and schedules transfer as the contracts are created
From post-registration fixes to source-based re-contracting

I first reviewed how the CX team listed targets and managed contract-specific changes in Excel. Replacing that familiar workflow entirely would increase the effort needed to understand and adopt the new feature. I therefore introduced the platform’s first use of Excel-style UI and interactions, aiming to retain as much of the existing workflow as possible while handling contracts together.

Operators load the contracts to copy by searching on screen or entering previous contract IDs in Excel. Collection manuals, notes, and tags carry over, leaving only the changed fields to edit. I limited the feature to collection contracts and specified that every new contract would link to its predecessor.

With designers and developers, I specified an editor for comparing contracts in rows and columns and copying or pasting cells. Shared values, such as a re-contract start date, can be changed in bulk, while prices that vary by contract can be adjusted individually. Operators also need to distinguish the contract and value they are editing, so selected cells that were hard to identify in design QA were included for correction.

  1. 1. Copy one contract

    The single-contract copy confirmation dialog on the previous contract detail page, showing the explanation and copy button for creating a re-contract from existing information. Contract names, IDs, filenames and account information are blurred.
  2. 2. Edit the copied details

    The period tab of the contract creation page opened after copying one contract, with individually editable signing and term dates, schedule transfer and auto-renewal settings. This is an unsaved draft. Account information is blurred.
Before: copying and editing contracts one at a time
The bulk-copy page with its title, information tabs, an editing table populated from several existing contracts and the creation button. Contract IDs, names and company identifiers are blurred.
After: loading an existing contract and editing what changes

Input Validation

Finding and Correcting Editing Errors Before Creation

I retained flexible spreadsheet editing while separating checks during input from checks before submission, so invalid values would not lead to multiple incorrect contracts and later correction requests.

I specified checks for required values, date formats, and the relationship between start and end dates, with errors marked in the affected cells. Operators need to locate values such as an end date earlier than its start date while editing, so they can correct them before creating contracts even when working across many rows.

The period table in bulk copy, with the first contract’s start date set to 2027-01-15 and its end date to 2027-01-14. The earlier end-date cell remains marked invalid, identifying where a correction is needed. Source contract IDs are blurred.
Cell validation: an end date earlier than the start date

An invalid end date remains in the period tab after an operator moves to the basics tab. To catch errors outside the current view, I required every tab to be checked again when Create is selected. An error blocks submission before a request reaches the server and returns the operator to the affected tab and cell for correction.

Clicking Create from the basics tab while a period error remains returns the editor to the period tab, showing an invalid-field message and the affected cell. No creation API request was sent at this stage. Source contract IDs are blurred.
Pre-submit validation: checking errors across tabs and blocking creation

Transfer Policy

Separating Editable Fields from Automatic-transfer Eligibility

Valid input does not by itself mean that existing collection work and schedules can transfer to a new contract. Changed contract information can affect past processing relationships as well as subsequent collection and billing.

Unlike a contract name or signing date, a change to waste type or discharger registration information requires checking whether previous collection work and Allbaro handover information still fit the new contract. I specified separate automatic-transfer checks even for fields that operators can edit. I also worked through settlement and contract-operation requirements with accounting and the CX team.

Adding a processor can preserve the processing route recorded for existing work. Replacing or removing one could leave the facility that actually handled the work absent from the new contract, so I limited automatic transfers to additions that retain existing processors. Switching between bag delivery and other plans was also excluded because it changes the work type and billing criteria.

AreaTransfer allowed after changeConditionalChange excludes transfer
BasicsName, approval state, nature, e-contract IDProcessor (only if added)Waste type, discharger registration info
PeriodSign date, term (start/end), auto-renew flag--
RateDiscounts / surchargesPlan type, plan fields-
Billing / taxTaxable & VAT-included flags--

Contract Transition

Selecting Transfers at Creation and Applying Them at Transition

Some re-contracts need neither collection-work transfers nor schedule changes. I therefore made the two separate choices.

For re-contracts created in advance, the transfer choices are recorded and processed when the actual start date arrives and the contract transitions. Unbilled-work and schedule transfers follow the policies defined in the re-contract process redesign. Even when several new contracts share a predecessor, only one can receive automatic transfers, preventing the same work from moving to multiple contracts and making the basis for billing and collection unclear.

The bulk-copy page with its title, information tabs and an editing table populated from several existing contracts. The schedule and work tab separates unbilled-work transfer from schedule reassignment. Source contract IDs and contract names are blurred.
Selecting work and schedule transfers in bulk copy

Discounts and surcharges valid for the new contract term carry over. The Allbaro disposal plan is also needed for later handover documents, so I required a copy attempt rather than making it optional. I distinguished how each copy item applies alongside the selectable transfers.

OptionApplicationDescription
Task-amount transferOpt-inMove unbilled work to the new contract (same logic as re-contract transfer)
Schedule reassignmentOpt-inLink the previous contract’s courses and schedules to the new contract
Discount/surcharge copyOnCarry over discounts/surcharges valid for the contract period
Allbaro disposal-plan copyMandatoryCopy it to the new contract (contract still succeeds if it fails)

Asynchronous Processing and Exceptions

Keeping Created Contracts and Following Up on Failed Items

A bulk copy of up to 300 contracts must not stop because one item fails. With developers, I defined separate results for contract creation and disposal-plan copying so completed work would not need to be repeated.

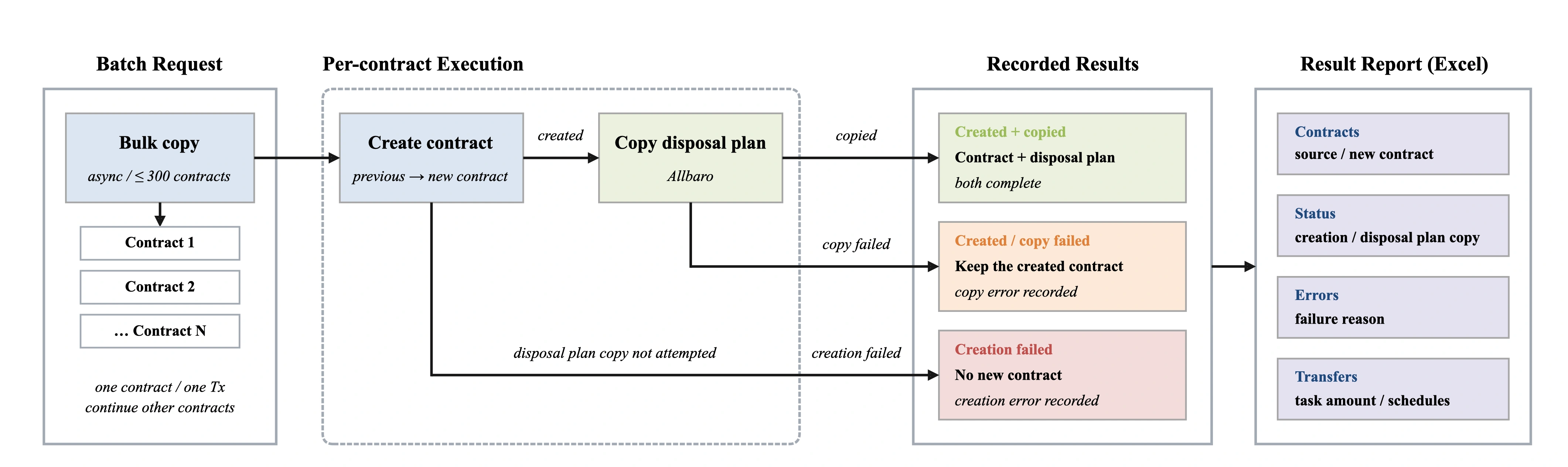

Run an asynchronous bulk copy: Up to 300 contracts, each processed independently. Contract and disposal plan succeed (The new contract is created and its disposal plan is copied) → Review successful results, Compare source/child contracts and transfer details, Contract created. Contract creation fails (If contract creation fails, skip the disposal-plan copy and record the failure reason) → Inspect the failure reason, Identify the failed item while other contracts continue, Creation failed. Only the disposal-plan copy fails (The contract exists but its disposal plan was not copied) → Keep the created contract, A failed disposal-plan copy does not reverse contract creation, Contract created
A batch that separates contract creation from disposal-plan copy results

Even after input validation passes, the server can fail to create a contract if its source is missing or creation conditions are not met. I specified independent processing for each contract in the asynchronous batch, recording failure reasons while allowing other contracts to continue. A failed contract creation also skips the disposal-plan copy.

The bulk-copy result dialog displaying an actual server response: one test request, zero successes and one failure, with result-download and failed-contract review buttons. A request with a missing source contract reproduced this failure path. Identifiers are blurred.
Creation failure: showing the failed count and follow-up controls

If the contract is created but its disposal-plan copy fails, the contract is kept. Cancelling a completed contract because the plan failed to copy would make operators repeat work already done. Separating the two results lets them follow up on the uncopied plan without duplicating an existing contract.

I specified progress during execution and total request, success, and failure counts afterward. The Excel results include source and new contracts, failure reasons, changed schedules, and transferred work. Operators can compare the actual creation results and continue the follow-up work that remains.

The bulk-copy result dialog after actually creating two contracts on the test server, showing two total requests, two successes, zero failures and a result-download button. Work and schedule transfers were not selected. Source contract IDs are blurred.
Creation success: confirming both requested contracts were created

I also distinguished an item excluded by automatic-transfer conditions from an error during an attempted transfer. These require different follow-up checks, so the results record eligibility exclusions and processing errors separately.

Results and Lessons

Connecting Bulk Creation with Collection and Billing

The workflow changed from creating re-contracts individually from an Excel list to loading existing contracts together, editing only what changes, and creating the new contracts in one batch. Collection manuals, notes, and tags carry over, and invalid input can be corrected before creation. Familiar editing in rows and columns remains, while repeated information copying and creation steps are reduced.

Collection-work and schedule transfers are selected during contract creation and processed at the actual contract transition. Creation and transfers previously handled across three teams became part of the bulk-copy workflow. After the re-contract process redesign and bulk copy were introduced together, manual support requests fell from 80 to 27.

Post-adoption survey feedback indicated that re-contract work previously taking four to five hours could be completed in two to three hours.

MetricBeforeAfter
Manual support after re-contract creation80 requests27 requests
Re-contract work time (survey)4–5 hours2–3 hours

The planning challenge extended beyond how many contracts could be created at once. It required retaining the familiar workflow while considering collection and billing after contract transition. Distinguishing transfer eligibility, execution timing, and the items needing follow-up made it possible to connect multiple re-contracts into one workflow.
